310S Welding & Fabrication: Inputs for a Workable Production Route

A buyer-focused 310S fabrication guide covering base metal, joints, WPS/PQR, filler approval, heat input, distortion, cleaning, inspection and repair.

Welder performing controlled autogenous TIG welding on clamped stainless sheet
A stable fixture, intact torch, complete PPE and controlled seam illustrate the inputs needed for qualified production.

Updated

A workable 310S fabrication enquiry starts with confirmed base material and a controlled drawing, then connects joint design, WPS/PQR, filler approval, cutting, forming, welding, cleaning, inspection and repair. Type 310S / UNS S31008 and EN 1.4845 are visible identifiers on the cited producer route, but the purchase standard and MTC control the material received. ISO cutting and general-tolerance standards apply only within their stated and contractual scope. The responsible welding or engineering authority—not the supplier’s general guide—must approve filler, procedure and acceptance criteria for the actual service.

Quick Facts for Buyers

Visible identity
Type 310S / UNS S31008 and EN 1.4845Source scope: Producer identifiers on the cited Therma 310S route; not a universal cross-standard substitution instruction.
Cutting reference
ISO 9013 addresses thermal-cut quality and tolerance classificationSource scope: Official standard scope; it does not establish the finished tolerance of a formed, welded or machined part.
Welded tolerance
ISO 13920 supplies a general welded-construction frameworkSource scope: Official standard scope; individually stated drawing tolerances and project provisions control where specified.
Untoleranced dimensions
ISO 2768-1 applies only when invoked for dimensions without individual tolerance indicationsSource scope: Official current-edition catalogue scope; it is not a default override of drawing requirements.
Process screening
Longitudinal-seam and narrow-gap routes require order-specific feasibility reviewSource scope: Published equipment or process examples; not proof of 310S procedure qualification, capacity or finished-part acceptance.

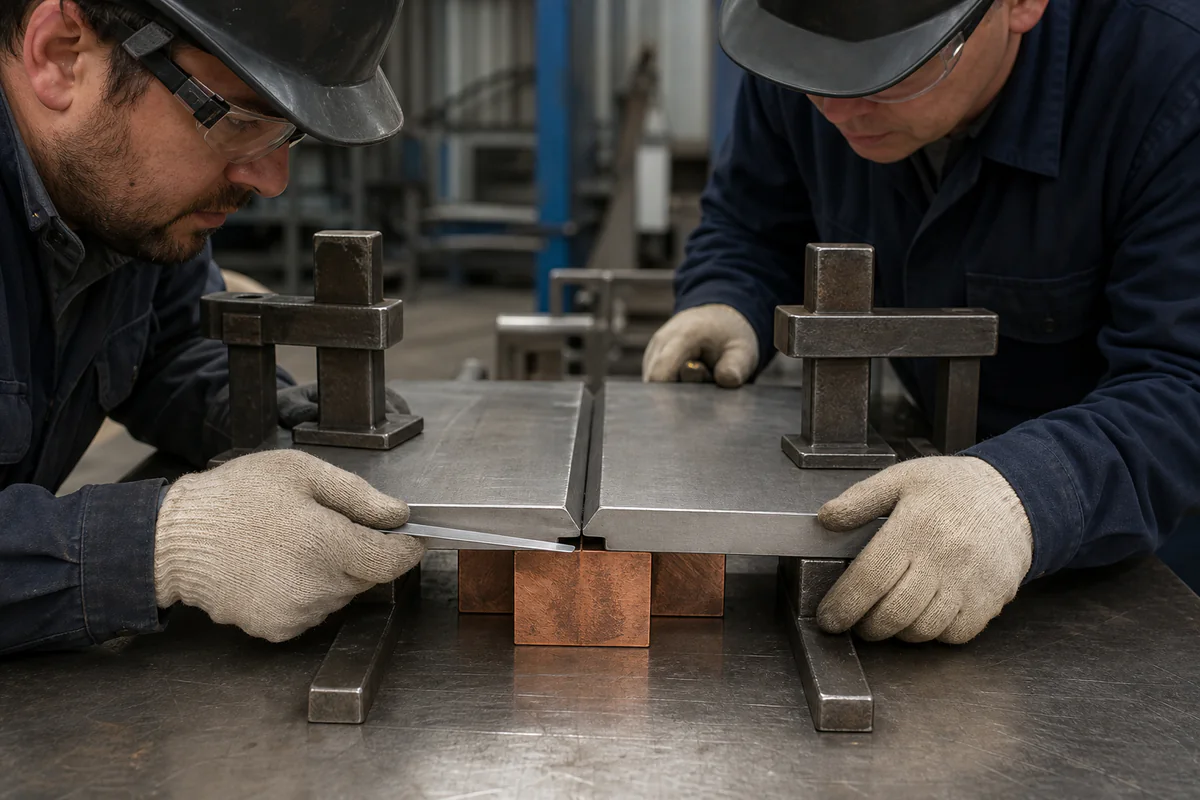

Two fabricators checking the root gap of clamped beveled stainless plates in a rigid fixture
Joint alignment, backing, restraint and root-gap control should be confirmed before welding starts.

The fabrication route is an order-specific chain, not a list of isolated shop capabilities. Material identity affects procedure qualification; joint geometry affects heat input and inspection; distortion affects machining allowance; cleaning affects final surface acceptance. The quotation should explain which inputs are confirmed, which are conditional and which require approval before production. It must not imply that equipment positioning accuracy, a published process example or a material data page guarantees the finished part.

Plan cutting and forming around the finished part

Begin with the delivered geometry and work backward to the starting form. Identify whether the part begins as plate, sheet, coil, strip, pipe or tube, bar, forging or an existing assembly. Put the finished dimensions, individual tolerances, datums, edge conditions, forming radii, welds, machining allowance and surface requirements on the controlled drawing.

ISO 9013 can be invoked for thermal-cut quality and tolerance classifications within its scope. It does not replace the finished-part drawing. A cut blank can still change during forming, fit-up, welding, straightening or machining. Equipment positioning accuracy is a machine reference and not a finished-part tolerance. It does not establish total process capability for a specific 310S component.

Define the inspection stage for each important dimension. A cut size may be checked before forming, while profile or hole position may control after welding and machining. If the fabricator must develop a flat pattern, agree whether the buyer approves it and which finished datums govern. State whether thermal-cut edges require machining or other preparation before welding.

Base-Metal Confirmation

Confirm the base metal before procedure or price is treated as final. The cited producer route visibly identifies Type 310S / UNS S31008 and EN 1.4845. Those identifiers do not replace the ordered product standard, and they do not create automatic equivalence with other names.

The material line should include:

  • designation accepted by the project;
  • governing product standard and edition;
  • product form, dimensions and supply condition;
  • any purchaser chemistry or test options;
  • required inspection document and traceability;
  • surface, edge and heat-treatment condition.

At receipt, match marking, heat or lot, dimensions and condition to the material certificate and purchase order. If positive material identification is required, define method, extent, acceptance and records. Quarantine a mismatch until the authorized buyer or engineering function issues a disposition.

Base-material confirmation extends to attachments, backing, inserts and dissimilar members. A WPS qualified for one route may not cover a change in standard, form, thickness or grouping. The responsible welding authority decides whether the existing qualification remains valid.

Joint Design

Joint design controls access, deposition volume, dilution, restraint, root quality and examination. Prepare a weld map with joint type, section on both sides, included angle or preparation, root face, root opening, backing arrangement, welding side, position and accessibility. Identify any seal weld, intermittent weld, attachment or temporary weld.

The design authority should check load path, fatigue or cyclic demand where applicable, thermal expansion and service exposure. A narrow groove may reduce deposited volume in an appropriate route, but it also changes access, sidewall fusion risk, equipment requirements and qualification variables. Published narrow-gap or longitudinal-seam examples are only screening evidence. They do not prove that a specific 310S joint, diameter, thickness or acceptance class can be produced.

Resolve interfaces before cutting

Review joints at thickness transitions, formed corners, nozzles, supports and dissimilar materials. Mark inspection access and any surface that cannot be reached after assembly. Decide whether the joint is completed before or after forming and how shrinkage will affect the datum scheme. If a backing piece remains in service, identify its material and acceptance.

The supplier can propose a manufacturable preparation, but the authorized design and welding functions must approve changes. Record the approved joint on the drawing and WPS rather than relying on a quotation note.

WPS / PQR

The WPS tells production how to weld; the PQR supports the procedure within the applicable qualification rules. The RFQ should name the design or construction code, welding qualification standard, required procedure status and approval route. “WPS required” is incomplete if no one knows whether the buyer supplies it, the fabricator develops it or a third party witnesses qualification.

Provide the base-material route, thickness range, joint, process, position, filler responsibility, shielding or backing requirements, service condition and examination standard. The responsible welding authority then determines essential and supplementary variables, test coupons, ranges of qualification and any welder or operator qualification.

Establish document gates

A practical gate sequence is:

  1. preliminary route reviewed for quotation;
  2. joint and material inputs frozen;
  3. WPS/PQR package submitted;
  4. responsible authority approves or comments;
  5. production released against approved revision;
  6. weld and inspection records returned with the part.

If production variables change, stop and check whether reapproval or requalification is required. Do not retrospectively describe a shop practice as an approved WPS. The project record should connect each weld or weld map location to the applicable procedure and qualified personnel.

Before release, compare the WPS revision named on the traveler, weld map and approval register. The package should make obsolete revisions unavailable at the work point and define who may authorize a controlled change. This is a document-control check as much as a welding check.

Filler Approval

Filler choice remains with the responsible welding or engineering authority. That decision can depend on base-material route, joint, dilution, service temperature, atmosphere, mechanical design, code, availability and examination. A familiar commercial classification or a supplier proposal is not a universal instruction.

The approved WPS should state filler classification, applicable standard, product form or size, manufacturer or trade-name control when required, batch or lot traceability, storage and conditioning, and any change-control rule. For dissimilar joints, review both base metals, dilution and the service conditions at the joint. The weaker or more environmentally exposed part of the combination may control.

The purchase order should state who supplies filler, who verifies certificates and who can approve substitution. If the supplier is asked to recommend an option, label the recommendation “subject to welding/engineering authority approval” and do not release production until that approval is documented.

Heat Input

Heat input is one procedure input among current, voltage, travel speed, process efficiency assumptions, bead size, interpass condition and sequence. It influences fusion, heat-affected zone, distortion and productivity, but a generic numeric window should not be copied into an order without checking the qualified procedure.

Ask the welding authority to define how required variables are measured and recorded. Identify interpass control, cleaning between passes, arc-start and stop treatment, run-on or run-off provisions and any restrictions on weaving or bead placement where the procedure requires them. For automated welding, define equipment, control and data-record expectations.

Heat input also connects to geometry. Thin sheet, a thick restrained joint and a dissimilar attachment need different route reviews. The production plan should show where dimensional checks occur and whether welding alternates between sides or segments. Any thermal treatment before or after welding requires design and procedure approval; do not infer it from grade identity.

Distortion

310S fabrication can accumulate movement from cutting, forming, fit-up and weld shrinkage. The route should manage that movement against final datums, not promise “no distortion.” Start with joint symmetry, deposition volume, sequence, restraint, preset, balanced welding, temporary attachments and machining allowance.

State which corrections are permitted. Mechanical straightening, localized heating or re-forming can affect thickness, surface, residual stress and dimensions. The responsible authority should approve a correction method and its inspection. If correction is prohibited on a critical surface, put that limitation on the drawing.

Use dimensional checkpoints:

Stage Typical check Decision
Cut blank Outline, edge and reference marks Release to forming
Formed part Radius, profile, opening and thickness where required Release to fit-up
Fit-up Root condition, alignment and restraint Weld hold point
During welding Sequence-sensitive dimensions Continue or adjust within plan
Final Drawing dimensions, profile and datums Accept, machine or approved repair

ISO 13920 can provide a general tolerance framework for welded constructions when the contract invokes it. The official scope also recognizes that individually stated drawing tolerances control and that complex structures may need special provisions. Resolve the class, measurement condition and any tighter individual requirement before fabrication.

Cleaning

Cleaning requirements run from incoming material through final packing. Define controls for carbon-steel contamination, marking media, cutting residue, forming lubricants, grinding abrasives, weld slag or spatter, heat tint, pickling chemicals and rinse quality where relevant. Use tools and consumables suitable for the specified stainless surface.

The drawing or specification should state the final surface and how it will be assessed. “Stainless finish” is too vague. Identify whether welds remain as-welded, are locally cleaned, blended to a defined contour or treated by a specified chemical process. If grinding is allowed, define the permitted area and minimum section.

Cleaning cannot repair lack of fusion, an unacceptable undercut or a dimensional defect. It also cannot be assumed to qualify a surface for a particular service. The project authority chooses the necessary surface treatment and acceptance standard. Protect the accepted surface during handling, assembly, marking and export packing.

Inspection

Inspection must follow the approved design and procedure. Name the method, extent, timing, acceptance standard, personnel qualification and record. “Full inspection” has no usable meaning without those fields.

Incoming inspection confirms material and documents. Fit-up inspection checks joint preparation, cleanliness, alignment and WPS availability. In-process inspection can verify required procedure variables and intermediate dimensions. Final inspection can include visual, dimensional and specified nondestructive examination, followed by marking and dossier review.

ISO 2768-1 addresses general tolerances for linear and angular dimensions without individual tolerance indications. Use it only when the drawing or contract invokes it and defines the applicable class. It does not override an individual dimension, a weld-specific tolerance or a datum-based geometric requirement. ISO 13920 likewise applies only as agreed and within scope.

For dimensional inspection, state the datum scheme, instrument or method where important, temperature condition, sampling or coverage and report format. For NDE, identify weld locations, method, extent and acceptance criteria. If a third party witnesses material identification, procedure qualification or final tests, include notification time and release authority.

Repair

An approved repair route protects both technical acceptance and traceability. Define what counts as a repair, who can authorize it and when engineering review is mandatory. Surface blending, weld excavation, insert replacement and dimensional correction can have different controls.

A repair instruction should include:

  • defect identification and location;
  • disposition and approval reference;
  • removal method and limits;
  • verification that the defect is removed;
  • repair joint preparation and WPS;
  • filler and personnel requirements;
  • repeat visual, dimensional and NDE scope;
  • final marking and record update.

Do not allow repeated repair cycles by default. The responsible authority should set any limit or requalification requirement based on the code and component. A concession or deviation must identify the affected drawing requirement and carry written approval before release. Final documentation should show the original finding, repair performed and acceptance evidence.

Project Solution

A Project Solution is a generic order workflow, not a statement that a customer part has been fabricated or tested. Hechuang Stainless Steel can review a proposed material and production route against the information supplied.

The buyer provides the design basis, approved drawing, service conditions and acceptance requirements. The fabrication review can then return:

  1. confirmed starting-material route and document basis;
  2. proposed cutting, forming, joint and welding sequence;
  3. WPS/PQR and filler approval responsibilities;
  4. dimensional checkpoints and machining allowance;
  5. cleaning, inspection and repair controls;
  6. exceptions, questions and approval gates;
  7. final document and packing schedule.

Any technical change should be issued for approval to the buyer’s named authority. The accepted drawing revision, purchase order, approved procedures and inspection plan become the production baseline.

Use the 310S authority hub for material context, the processing page for route categories, the quality page to frame inspection questions and the product-form guide to define the starting material. These pages support enquiry preparation; they do not replace project specifications.

Fabrication RFQ

Copy and complete this enquiry structure:

  • Base metal: designation: [ ]; product standard and edition: [ ]; form and thickness: [ ]; condition: [ ]; MTC and traceability: [ ].
  • Drawing: number and revision: [ ]; quantity: [ ]; finished datums and tolerances: [ ]; cut-edge class or condition: [ ]; formed geometry: [ ]; machining allowance: [ ].
  • Service: normal and peak metal temperature: [ ]; atmosphere: [ ]; cycling: [ ]; loads and restraint: [ ]; governing design or construction code: [ ].
  • Joints: weld map: [ ]; preparation: [ ]; access and position: [ ]; dissimilar materials: [ ]; backing: [ ]; temporary attachments: [ ].
  • Procedure: qualification standard: [ ]; WPS/PQR supplied by: [ ]; approval authority: [ ]; welder or operator qualification: [ ]; production record: [ ].
  • Filler: selection authority: [ ]; classification and control: [ ]; certificate and traceability: [ ]; substitution approval: [ ].
  • Process control: heat-input variables: [ ]; interpass control: [ ]; sequence and restraint: [ ]; dimensional checkpoints: [ ]; correction permissions: [ ].
  • Cleaning: contamination controls: [ ]; weld cleaning: [ ]; surface finish: [ ]; pickling or passivation requirement: [ ]; packing protection: [ ].
  • Inspection: incoming: [ ]; fit-up hold point: [ ]; visual: [ ]; dimensional: [ ]; NDE method, extent and acceptance: [ ]; third party: [ ].
  • Repair and release: repair approval: [ ]; repeat examination: [ ]; deviation authority: [ ]; document dossier: [ ]; marking: [ ]; destination and schedule: [ ].

Prepare the drawing, weld map and project specifications. Mark every missing decision as an open technical query before quotation acceptance.

Conclusion

A reliable 310S fabrication order aligns material identity, drawing, joint, qualified procedure, filler approval, process control, cleaning, inspection and repair. Official standards can define agreed portions of cutting or general tolerance, but they do not replace the finished-part requirements. Published welding equipment routes can support feasibility screening, not procedure qualification or capability guarantees.

Submit the RFQ summary first through Request a Quote. After sales replies, transfer controlled drawings and files through info@hechuangss.com or WhatsApp at +86 15251530098. The website form does not accept uploads. Hechuang Stainless Steel can review route feasibility, documentation and exceptions for the stated part. The responsible design, welding and quality authorities retain approval of material, WPS/PQR, filler, tolerances, inspection acceptance and any repair.

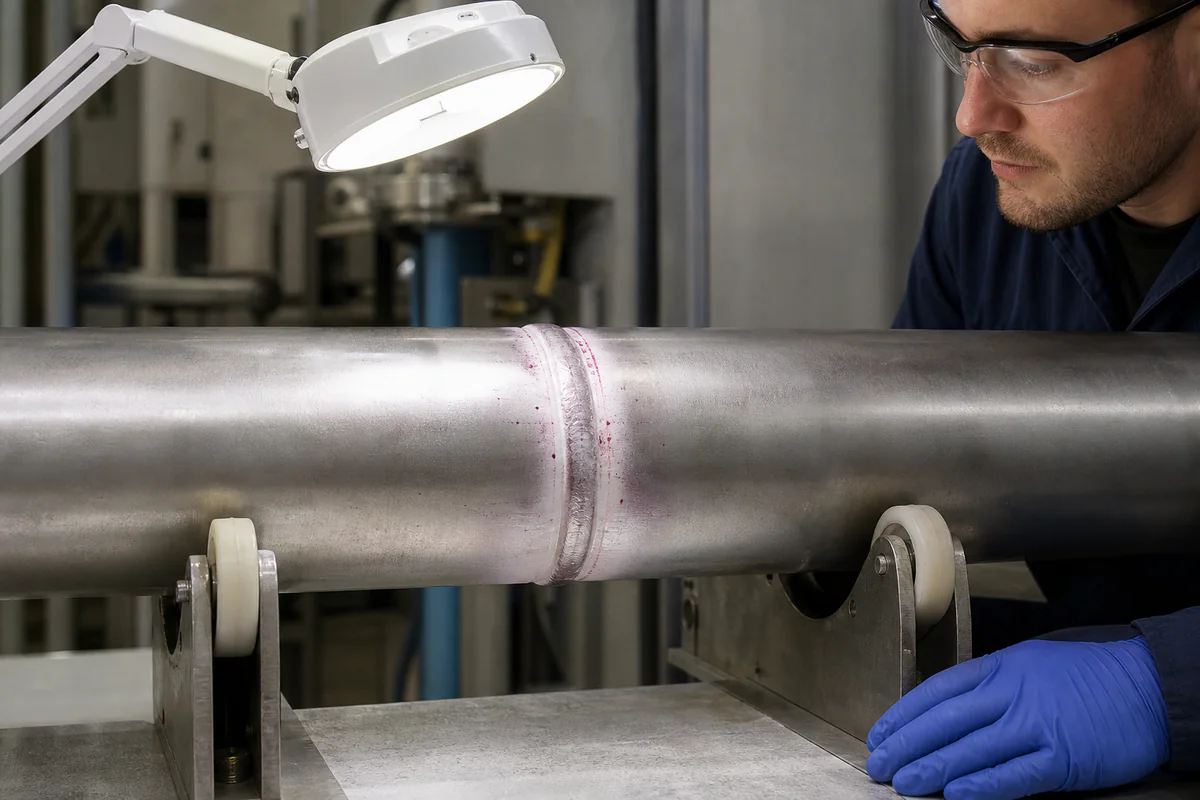

Inspector examining a supported stainless butt weld after color-contrast penetrant testing
A fixed inspection light and visible developer band support weld-surface review after the agreed examination process.

Frequently asked questions

  1. Can 310S be welded using a standard shop WPS?

    Only if the responsible authority confirms that the WPS/PQR covers the actual base-material route, thickness, joint, process, position, essential variables, design code and service. A generic grade statement is not approval.

  2. Who approves filler metal for 310S?

    The responsible welding or engineering authority selects and approves filler through the project WPS/PQR and service review. Producer or supplier information may support that decision but cannot serve as a universal instruction.

  3. Does ISO 9013 define the final tolerance of a welded part?

    No. It provides thermal-cut quality and tolerance classifications within its scope. Forming recovery, fit-up, weld shrinkage, restraint, machining, datums and measurement all affect the finished part.

  4. Can ISO 2768-1 be assumed when a drawing is silent?

    Do not assume it. State in the drawing or order whether ISO 2768-1 applies, which class is invoked and which dimensions have individual tolerances. Resolve conflicts before release.

  5. How should a buyer control welding distortion?

    Require a reviewed joint, sequence, restraint and heat-input plan; define dimensional checkpoints, permitted correction, machining allowance, datums and final acceptance. The exact controls belong in the approved procedure and production plan.

  6. What must a repair instruction include?

    Identify defect limits, removal and verification method, repair WPS, repeat-inspection scope, dimensional recheck, traceability, approval authority and disposition. Unapproved cosmetic blending is not a repair plan.
